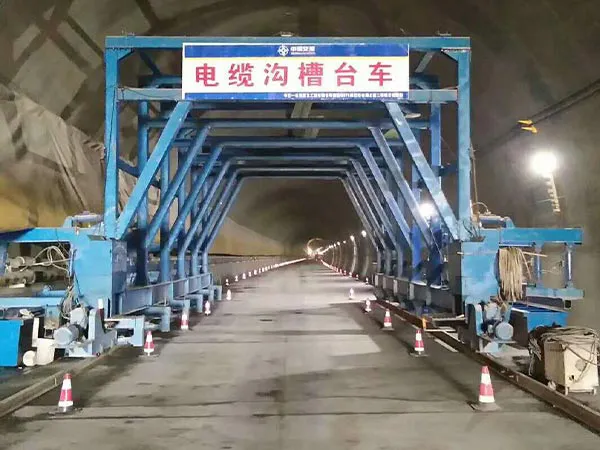

Tunnel Formwork Bypass Channel

A convenient structural design. This channel is usually located on the side wall or bottom of the tunnel. Its main function is to ensure that water, mud or other media can pass smoothly during construction without affecting the construction of the main formwork system and concrete pouring.

Length of each lining of the trolley

L=12100 mm

Clearance size

B  H = 6500 mm  4500mm

Trolley walking speed

6m / min

The amount of horizontal adjustment

100mm (single side)

System working pressure

P = 12MPa

Rail center distance

7600mm  5mm

The maximum stroke of the cylinder

Vertical cylinder: 300mm
Secondary cylinder: 900mm
Lateral cylinder: 300mm
Horizontal cylinder: 200mm

TUNNEL FORMWORK CHANNEL INSTRUCTIONS

The tunnel formwork channel is a non-standard product specially designed and manufactured for the concrete lining of water tunnels such as tunnels and culverts. It has the functions of vertical mold and demoulding function, high surface finish of lining and fast lining speed. The working process of the steel formwork trolley is carried out in the following steps:

FIRST, CHECK WHETHER THE TUNNEL CONSTRUCTION CONDITIONS MEET THE DESIGN REQUIREMENTS OF THE TEMPLATE TROLLEY:

Since the formwork trolley is a non-standard equipment, the conditions of use must meet the design requirements before lining.

Check whether the road surface elevation and road surface condition meet the design requirements, the road surface elevation: as shown in the figure; the road surface condition: concrete road surface.

Check whether the sleepers and rails meet the design requirements;

Check whether the outer surface of the steel formwork is coated with a release agent.

SECOND, THE VERTICAL MODEL

After the tunnel formwork channel walks to the lining position, the vertical form can be established, and the tunnel formwork channel is in the demolished state before the vertical mold. The vertical mold is carried out in the following steps:

After the trolley is in the lining position, the gantry support jack is supported on the rail and tightened.

Start the hydraulic motor and operate the manual reversing valve handle to lower the vertical cylinder and the secondary cylinder. Adjust the Tunnel formwork channel template to a predetermined height;

Operate the manual reversing valve handle to translate the horizontal cylinder. Adjust the Tunnel formwork channel template so that its centerline is aligned with the lining centerline, and then operate the manual directional valve to bring the straight wall template to the desired position and tighten the lateral jack.installed the ground screw jack, plug board.

THIRD, GROUTING

Grouting can be performed after the vertical mold is completed. Before the grouting, the outer surface of the tunnel formwork channel should be coated with a release agent to reduce the surface tack during demolding. When grouting, take care to ensure that the height of the concrete in the middle of each tank is basically the same, preventing the template from running.

Pay attention during the grouting work: Before each grouting, check whether the lead screw and the jack are loose to prevent the trolley from deforming during grouting.

FOURTH, DEMOULDING

After the grouting is completed, the concrete must be allowed to solidify for a certain period of time before the demolding can take place. Demolding is performed in the following steps:

Remove the connection structure of the side jack, the screw jack and the plug plate and all the templates.

Start the hydraulic system, operate the manual reversing valve handle, and control the secondary cylinder. The tunnel formwork channel is removed from the concrete surface; the manual reversing valve handle is operated to control the straight wall cylinder to make the straight wall template out of the concrete surface; the manual reversing valve handle is operated to control the main cylinder so that the trough shape is higher than the new lining Concrete surface

Put away the foundation jack.

FIFTH, WALKING

After the tunnel formwork channel is demoulded, the gantry support jack is first closed, and the walking motor can be started to walk. Pay attention to the following points when walking the tunnel formwork channel:

The steel formwork trolley must be completely stationary before it can be reversed.

When the slope of the rail is too large, and the trolley is slipping, you can sprinkle some dry sand onto the rail surface to increase the adhesion and make the slip phenomenon disappear. Repeated cycle of vertical mold, grouting, demoulding, and walking, completed the entire operation of the Tunnel formwork channel.

Precautions

Before each working cycle, check whether the rail is straight, whether the center distance of the rail is aligned with the center distance of the lining, and check the firmness of the rail. Before the trolley is in place, it is necessary to straighten the rails and strictly prevent the phenomenon that the gantry support jacks cannot be supported on the rails.

After each work cycle, check the tightness of the bolts and pins of each part, and re-inspect and tighten the various joints.

The trolley walking mechanism and the screw jack should be regularly buttered.

The hydraulic system should be free of leakage. The hydraulic oil should be clean. The pressure gauge switch should be opened during operation to observe the fluctuation of pressure at any time.

When the Tunnel formwork channel is walking, there should be no obstructions such as ducts and water pipes between the lower end of the formwork and the ground, so as to prevent the towing phenomenon when the trolley is walking.

For the safety of you and others, please operate the trolley according to the specifications and be diligent in maintenance to prevent all accidents.

ELECTRICAL PART DESCRIPTION

It is necessary to introduce a three-phase four-wire power supply, otherwise the leakage circuit breaker will not function as a leakage protection trip.
The green indicator on the panel of the power distribution box is the power indicator.
Oil pump motor thermal relay setting current: 11.6A.

Hydraulic system component table

NO.

Name

Specification type

unit

Quantity

Remarks

1

Main cylinder

YGJDK-125/70F

article

4



2

Translation cylinder

HSGK-100/50E8501

article

4



3

Side mold cylinder

HSGK-100/50E

article

8



4

Secondary cylinder

YGJDK-125/70F

Piece

16



5

Oil pump

PFE-XP-F320CFP

Piece

2



6

Throttle valve

LA-H10L

Piece

4



7

Oil level gauge

YWZ

Piece

1



8

Multiple way reversing valve

DLF-B15F-T/3C8P

Piece

2



9

Air filter

QVQ3

Piece

1



10

Motor

Y132S-4B3

Piece

1

3kw

11

Pressure gauge

Y60

Piece

1

0—25Mpa

12

Pressure gauge switch

KF-L8

Piece

1



 Template trolley electrical component table

NO.

Name

Specification model

unit

Quantity

Remarks

1

Leakage circuit breakers

NM10-100/330-100A

One

1



2

Fuse

RT14

One

2



3

Fuse core

RT14-20

One

2



4

Contactor

JT1-40A/38W

One

2



5

Motor

Y132M2-6

station

2

5.5Kw

6

Thermal relay

JR36-63 45A

One

1



7

Indicator light

AD11

One

3



8

Button

LA19-11

One

4



9

Distribution box

500x400x200

station

1


Routine maintenance of trolleys (level maintenance for each shift)

Job project

Technical requirements and instructions

Walking system

Drive chain and grease

Various bolts

There should be no looseness or slippery phenomenon

Various jacks, cylinders

Should be in the working size position when working

Grouting port, working window

No leakage

Plug board

When working, there should be no leakage and work well.

Walking mechanism (when walking)

Smooth transmission, no abnormalities

Check the joystick (no load)

It should be easy to operate, accurate in position and reliable in positioning

Steel formwork outer surface

It should be kept clean after demolding, remove the concrete that may adhere to it, and apply the release agent evenly and comprehensively.

Electrical control system

According to the electrical instructions

Hydraulic system



Check the amount of oil in the hydraulic tank

The amount of oil is sufficient

Check each tubing connector

No leakage, no aging

Check the oil temperature

The oil temperature remains at work 30-70C

Routine maintenance of the trolley (secondary maintenance for 15 cycles per work)

Job project

Technical requirements and instructions

Complete a maintenance project other than the maintenance work at this level



Jacks, work platforms

The jack rotates flexibly, the hinges must not be deformed, and the working platform should be stable and firm.

Machine



Check each bolt

Should be fastened without slipping

Weld of the gantry and upper arch

No cracking, otherwise it should be repaired

Overall size inspection

Height, width and clearance should be within the tolerance of the drawing design size

Next cycle rail laying inspection

Before each cycle, check whether the rail is horizontal, parallel and accurate, and whether the gauge is accurate. Whether the tunnel lining center and the gauge center are within the error tolerance.

Electrical control section

The working voltage is 380V, the voltage is stable, and no leakage is allowed.

Hydraulic system



Check the hydraulic system control components

Is it in a controllable state

Check each pipe and pipe joint

No leakage

Check system tightness

Eliminate leakage

Cleaning filter

Clean

 Routine maintenance of trolleys (three levels of maintenance for every 30 cycles)

Job project

Technical requirements and instructions

Complete the second guarantee project other than the maintenance work at this level



Electrical control section

The working voltage is 380V, the voltage is stable, and no leakage is allowed.

Hydraulic system



Replace hydraulic oil, oil filter

After cleaning the fuel tank, add anti-wear hydraulic oil

Debug system pressure (under no load)

Ensure that the oil pressure reaches the rated pressure of the pump

Debug lift cylinder base

Should be flexible, the maximum amount of translation must not exceed 80mm

HYDRAULIC SYSTEM INSTALLATION, USE, MAINTENANCE INSTRUCTIONS

Invent all parts and match the packing list.

Check if the fuel tank is clean, cover the fuel tank cap, and add 115 liters of clean YA-N46 hydraulic oil from the tank air filter.

According to the requirements of the cylinder layout

Before welding the pipe, the burr of the pipe head should be removed, (with a round file), and the high-pressure wind blows the debris inside the pipe.

The welded pipe should be aligned, welded, and not allowed to leak oil.

Pipe the pipe according to the requirements of the pipe, install all the gaskets, rings, and clean the debris in the pipe.

Connect the multi-way reversing valve and cylinder to the pipeline (the mechanical lock cylinder must be connected to the left and right valves of the multi-way reversing valve).

Note: There are no 1, 2 hoses.

Jog motor to check the motor steering, start the oil pump to test the various cylinders (the pressure has been adjusted at the factory). If the system pressure is not established (the cylinder does not move), first check whether the joints of the pipes are leaking oil, and if necessary, exclude them. Then adjust the relief valve to see the pressure from the pressure gauge is 12MP. After adjusting, close the pressure gauge switch and pay attention to the oil level.

Clean the oil filter element frequently and remove the filter debris. Replace it when it is blocked.

After the first refueling, the new oil will be replaced in three cycles, and the cleaning of the hydraulic oil will be replaced irregularly. It is recommended to replace the new oil in 30 cycles.

Simple fault analysis of electrical parts

Fault phenomenon

Reason

Approach

The motor does not start properly

the circuit fuse is broken

replace the fuse

the thermal relay normally closed contact JR is not reset

reset the contact to close it

normally closed contact bad contact

repair contacts

Poor contact or break between the start and stop buttons

connect the line, repair button point

One of the positive and negative buttons can control the motor and the other cannot control the motor.

There is a button contact in the anti-control button.

repair contacts

There is an interlocking normally closed contact in the positive and negative control buttons.

repair the contacts, make it closed

No positive or negative buttons can be activated

The reverse contactor coil is damaged.

replace the contactor coil

The thermal relay normally closed contact is not reset.

reset pad relay normally closed contact

Check if the power supply and plug are loose.

inspection, replacement

Check if the stop button is damaged or if its line is connected.

inspection, replacement
